Spears Creek Church Rd Widening
Districts 9, 10
The project will consist of potential improvements along the existing roadway from North of the intersection with Two Notch Road (US 1) and just before the westbound I-20 entrance/exit ramps, for a total length of approximately 2.3 miles. From Two Notch Rd to Earth Rd is 3‐lane, from Earth Rd to I‐20 is 5‐lane. A five (5) foot sidewalk will be constructed on both sides of Spears Creek Church Road throughout the entire length of the project.

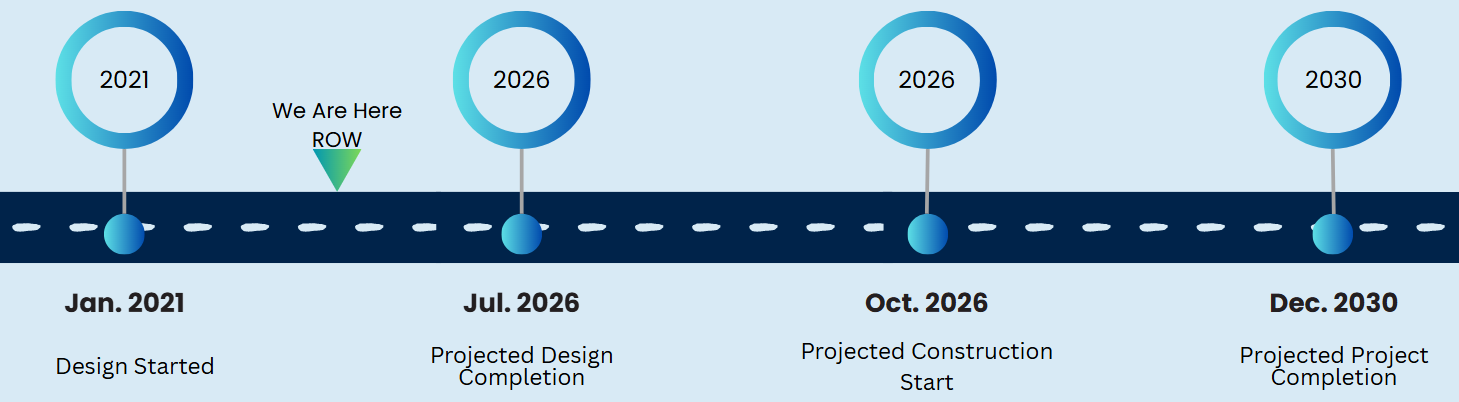

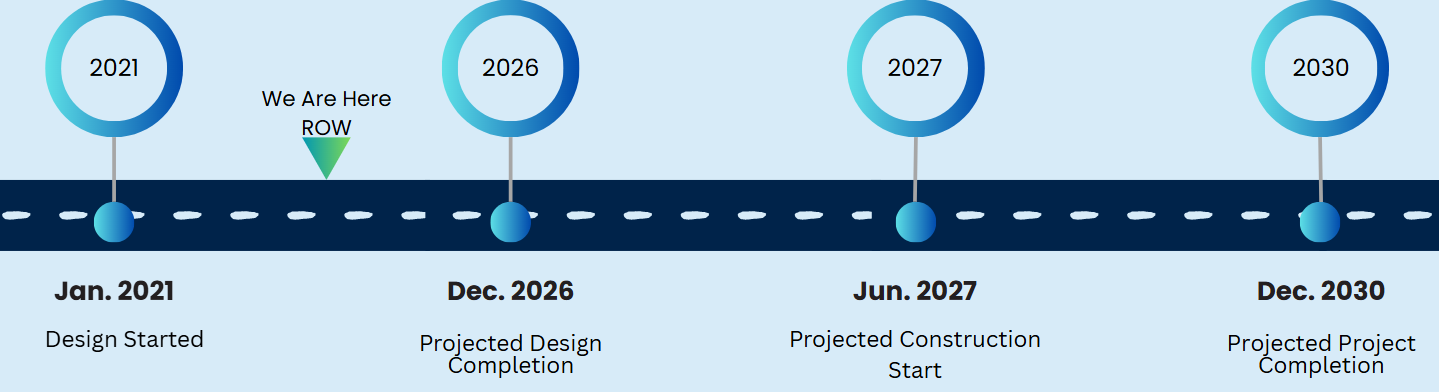

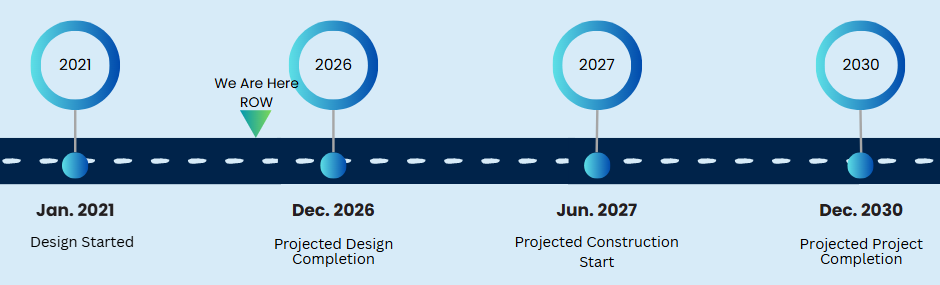

Project Status:
- The project plans are currently being updated to include five-foot sidewalks on both sides of the roadway to improve pedestrian accessibility and safety. To support this effort, SOM #5 was executed on May 1, 2026, and the design plans are being revised to incorporate the new sidewalk and associated drainage modifications, with anticipated completion by September 2026. Utility coordination is approximately 95% complete; however, additional coordination efforts are underway due to the sidewalk additions. The next steps include continuing work on the final utility reports, no-cost letters, and utility relocation plans, with the anticipated Final Utility Report expected by December 2026. Right-of-way acquisition is about 58% complete, comprising 52 tracts: 49 right-of-way acquisitions and 3 permanent or temporary easements. To date, 30 tracts have been successfully secured.

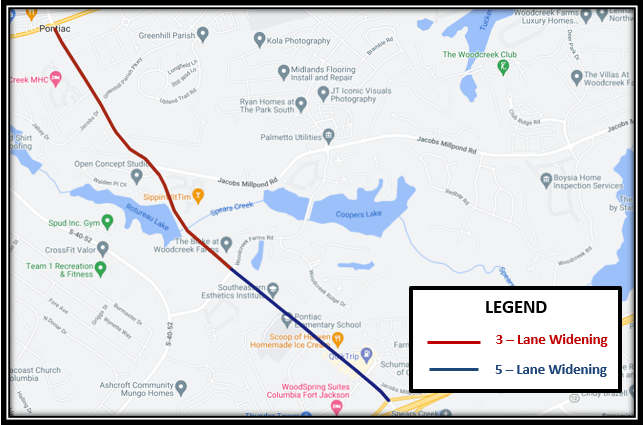

Planned Route:
